Part 2 of our 2025 guide on how to plan a medical college campus in India focuses on cost, phasing, and NMC approvals, the execution stage after design and zoning.
Setting up a medical college and teaching hospital requires clear visibility on CAPEX–OPEX ranges, infrastructure expansion, and the National Medical Commission (NMC) approval process, from Letter of Intent (LoI) to Letter of Permission (LoP) and final recognition.
As per the MoHFW (2024) and NMC Gazette 2023–24, every new college must operate a fully functional 300-bed teaching hospital and meet prescribed norms for lecture halls, labs, hostels, and staffing before LoP approval.
This section provides a data-driven roadmap covering:
NMC infrastructure requirements (2025)
CAPEX/OPEX benchmarks & phasing models
Approval timelines and common compliance risks
NMC Infrastructure Requirements (2025)

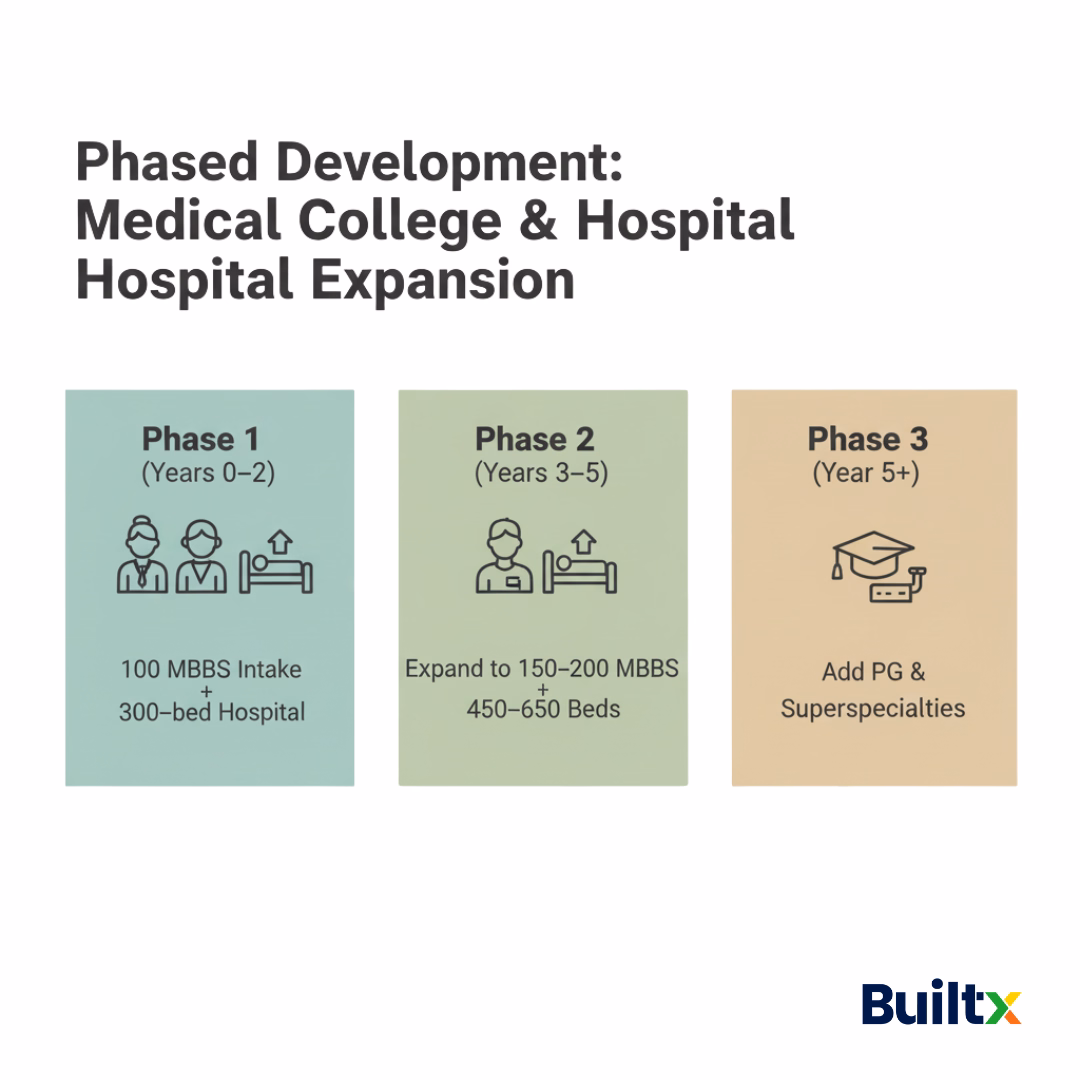

To start a medical college in India and maintain uninterrupted approvals, infrastructure must comply with National Medical Commission (NMC) norms across 5 years. The teaching hospital is mandatory from Year 1 and must expand annually with student intake growth.
Below is a quick, skimmable summary for promoters, architects, and project teams:
S. No.
Category
Year 1
Year 2–3
Year 4–5
1
MBBS Intake
100 students
Expand to 150
Optional expansion to 200
2
Teaching Hospital Beds
300+ operational beds
450–500 beds
650+ beds
3
Departments (Academic)
Pre-Clinical & Para-Clinical
Add Clinical Departments
Full Specialty + Superspecialty readiness
4
Lecture Halls
4 halls (120–180 seats each)
Add smart classrooms
6–8 large halls
5
Labs & Skill Training
Anatomy, Physiology, Biochem Labs + Skill Lab
Department-wise labs
Simulation & Research Centre
6
Library
1,000–1,500 sqm + e-resources
Expand reading rooms
Digital knowledge hub
7
Hostels
Student + Intern hostel
Add PG hostel
Faculty residence expansion
8
Faculty & Staff
As per NMC minimum norms
Scale with intake
Meet full academic + hospital staffing norms
Space Requirements (Indicative for 100 MBBS Intake)

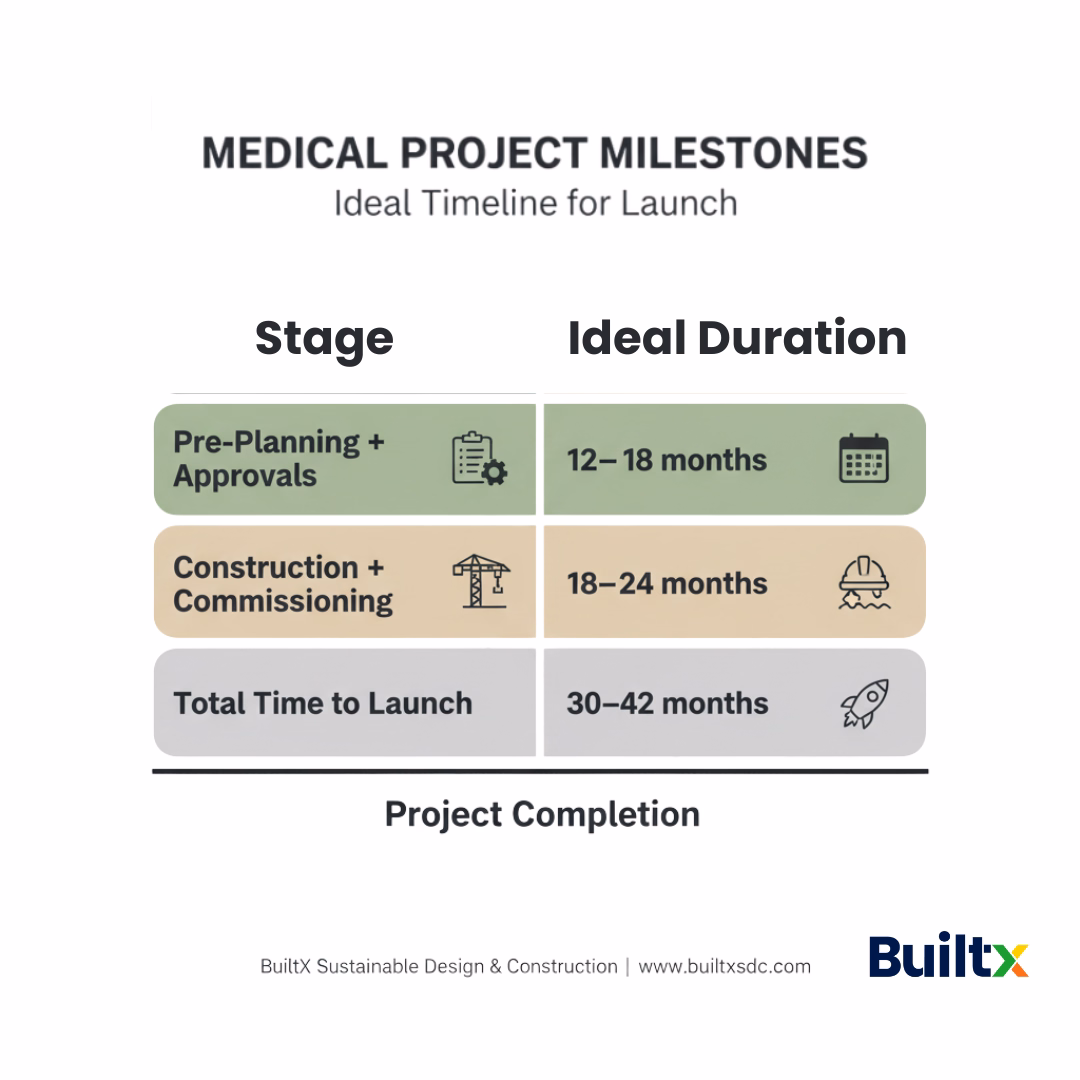

Regulatory Approvals & Timelines for Medical College Establishment (2025)
Setting up a medical college in India requires multiple layered approvals. A well-planned compliance roadmap prevents delays, show-cause notices, or rejection at inspection.
Below is a simplified breakdown of the approval journey:
Many projects fail at LoP stage because hospital patient load is insufficient at inspection. Start OPD services 12–18 months before inspection to build patient trust and records.
Top Approval Roadblocks
Inadequate hospital functionality
On-paper faculty without physical presence
Weak patient case sheets and data records
Missing residential facilities
Poor documentation & readiness for inspection
Solution: Maintain a “NMC Inspection File Room” from Day 1 with all evidence, photos, logs, and compliance documentation.
Top 10 Planning Mistakes to Avoid
Avoiding these saves crores, time, and reputation:
S. No.
Mistake
Impact
1
Starting construction before freezing master plan
Redesign + cost overrun (₹8–35 Cr)
2
Treating it like a university campus without hospital planning
NMC non-compliance risk
3
Hostels & residences as secondary priority
Faculty & student retention drops
4
Weak patient footfall plan
LoP rejection
5
No simulation centre
Poor rankings & PG approval barrier
6
Underestimating hospital OPEX
Financial struggle
7
Wrong land choice (low footfall)
Hard to scale
8
Overbuilding in Phase 1
Dead capital; cash flow issues
9
Faculty hiring delayed
Non-compliance at inspection
10
No provision for future PG & superspeciality expansion
Lost long-term growth
Conclusion
Launching a medical college and teaching hospital in India is a complex, multi-year journey that blends finance, infrastructure, and compliance. By aligning each phase from CAPEX budgeting and hospital expansion to LoP documentation, promoters can move confidently from planning to NMC recognition.
A forward-looking strategy not only ensures faster approvals but also builds campuses that remain financially sustainable and academically competitive for decades.
Are you planning to construct a medical college or hospital? BuiltX works with trusts, universities, and healthcare groups across India to plan and deliver sustainable, future-ready medical colleges and teaching hospitals that strengthen India’s healthcare ecosystem for generations. Book your free slot now!
