Introduction

Construction delays are more common than most project owners expect. Global studies show that large construction projects often run 20% longer than planned and exceed original budgets significantly, with only about half of projects finishing on time.

This makes accurate construction timeline estimation critical — not just for cost control, but for approvals, funding, and operational planning.

This guide is designed for hospital promoters, educational and CSR project owners, NGOs, and institutional developers, using an India-first approach supported by global benchmarks.

Inside this guide, you’ll learn:

  • What actually drives construction timelines
  • Typical duration ranges by project type and scale
  • A practical 5-step method to estimate timelines using quantities and productivity
  • India-specific approval and pre-construction timelines
  • How to add realistic buffers based on common delay patterns
  • A worked example for a mid-size institutional project
  • How BuiltX plans timelines for hospitals, schools, and CSR infrastructure

Note: All timelines shared here are indicative benchmarks, not guarantees. Final schedules should always be validated with your project team, site conditions, and local approvals.

What Actually Drives a Construction Timeline?

When owners ask, “How long will my project take?”, the real question is:
Given the project constraints, what is a realistic construction timeline if execution is planned properly?

The actual timeline is driven by a combination of the following factors:

  • Built-up area & height: Larger floor areas and taller buildings naturally take longer due to increased structural work, services, and finishing scope. Basement construction significantly extends timelines because of excavation, waterproofing, and retaining structures.
  • Project type & complexity: A simple warehouse can be completed far faster than a hospital or institutional building of the same size. Facilities like hospitals, laboratories, and data centres involve dense MEP services, equipment coordination, and extended testing and commissioning phases.
  • Approval & pre-construction timelines: Before construction begins, projects must clear building plan sanctions, fire approvals, and other statutory permissions. In India, approvals in major cities typically take 45–100 days, depending on state systems and local conditions — and this period must be included in any realistic timeline.
  • Procurement & supply chain: While basic materials are usually available, specialized items such as HVAC systems, lifts, façades, and medical or lab equipment have longer lead times. Delayed procurement of these packages is a common cause of schedule overruns.
  • Labour productivity & site logistics: Construction duration depends on workforce strength, skill levels, and achievable daily output. Congested urban sites, limited access, and restricted crane usage often reduce on-site productivity compared to planning assumptions.
  • Contract strategy & project management: Turnkey/EPC contracts, clear scope ownership, structured scheduling, and professional project management significantly improve timeline predictability compared to fragmented multi-package execution.
  • External risk factors: Monsoons, holidays, funding delays, design changes, land or legal issues, and slow decision-making can all disrupt even well-planned schedules.

Checkout the Hospital Construction Cost in Indian in 2026

Typical Construction Timeline Benchmarks (2026)

These are high-level ranges seen in industry literature and practice. Use them only as a starting point – complexity and approvals can easily push projects to the higher side.

For Indian institutional projects (hospitals, schools, college blocks), a very rough rule of thumb used by many planners is:

S. No. Built-up Area Type (Typical) Concept-to-Commissioning (including approvals)
1 20,000–40,000 sq ft Small school block, clinic, hostel 12–16 months
2 50,000–80,000 sq ft 50–100 bed hospital, mid-size academic block 18–24 months
3 100,000–200,000 sq ft Multi-block campus, large hospital or office park 24–36 months

These ranges assume reasonable approvals, funding continuity, and coordinated design. Highly specialised medical or industrial facilities can exceed these ranges.

How to get hospital license in India


The 5-Step Method to Estimate Construction Timeline

Instead of asking “How many months will this take?”, treat timeline estimation as a simple calculation:

Duration = Quantity ÷ (Productivity × Effective Workforce)…adjusted for sequencing, dependencies, and buffers.

This 5-step method works for most building projects.

Step 1: Define Scope & Constraints Clearly

Before estimating time, clearly define:

  • Built-up area, number of floors, and basements
  • Project type (hospital, school, factory, office, residential)
  • Structural system (RCC, steel, PEB, precast)
  • Location and site constraints (urban vs. greenfield, access, working hours)
  • Design maturity (concept vs. GFC drawings)

Step 2: Break the Project Into Phases

Estimate timelines phase by phase, then combine them into a master schedule.

Typical phases include:

  • Pre-construction & approvals
  • Enabling works and foundations
  • Superstructure
  • Building envelope and MEP rough-ins
  • Internal finishes and services
  • Testing, commissioning, and handover

This approach makes both estimation and tracking far more reliable.

Step 3: Use Quantities & Productivity (Not Gut Feel)

Avoid blanket assumptions like “brickwork will take three months.”
Instead, use:

Time = Total Quantity ÷ Daily Output

For example, if total brickwork is 5,000 m² and your effective site output is ~100 m²/day, the activity takes ~50 working days, which may translate to 3–4 calendar months once sequencing and weather are considered.

Apply the same logic to excavation, RCC, formwork, plastering, and finishes.
What matters is not the exact norm, but that the contractor shows clear logic behind quantities, crew size, and productivity.

Step 4: Build a High-Level CPM Schedule

Once major activity durations are defined:

  • Sequence activities logically (structure → envelope → MEP → finishes → commissioning)
  • Identify overlaps where safe
  • Identify the critical path, the tasks that control total project duration

At a minimum, insist on:

  • A Gantt chart with phase-wise dates
  • Critical activities clearly identified
  • Key assumptions documented (slab cycle, crew size, shifts)

Step 5: Add Realistic Buffers

Most schedules fail because they assume perfect execution.

Industry data shows that large projects often overrun schedules by ~20%.

A practical approach:

  • Start with a productivity-driven base schedule
  • Add 10–15% buffer at activity level
  • Add another 10–15% project-level contingency for approvals, funding delays, scope changes, and supply risks

For example, if your base schedule is 18 months, communicate a 20–21 month realistic timeline with transparent reasoning.

Best Hospital Construction Company for Non-Profits

India-Specific Pre-Construction & Approval Timelines

No matter how efficient the contractor, construction cannot begin without:

  • Sanctioned drawings
  • Building permit
  • Fire NOC and applicable environmental clearances

What the data says
Under India’s Ease of Doing Business reforms, approval timelines have reduced significantly in many cities. Official figures show that construction permit timelines in major metros now typically range between 90–100 days, and several states have implemented single-window approval systems targeting approvals within 30–45 days.

What happens on the ground
In real projects, owners and designers still report:

  • 1.5–3+ months for standard building permit cycles in well-functioning urban local bodies (when documentation is complete)
  • Longer timelines where land titles, environmental sensitivity, heritage zones, height restrictions, or special authority clearances are involved

This makes approvals a critical part of the construction timeline, not a parallel afterthought.

Practical Owner Checklist for Approvals

To prevent pre-construction delays:

  • Initiate concept design and regulatory discussions early
  • Ask your design team to map all required approvals, including:

    • Building plan sanction
    • Fire NOC
    • Environmental or pollution control clearances (if applicable)
    • Special authority clearances (airport, highway, railway, defence zones)
    • Utility connections (water, sewer, power)

Also ensure:

  • A separate approvals timeline is built into the project schedule
  • Clear responsibility is assigned for documentation and follow-ups (architect vs. owner)

Hospital Floor Plan Guide 2026

How Long Construction Really Takes: An Owner’s View

Here’s a simplified owner-friendly matrix you can use to sanity-check proposals. These assume design is complete and approvals are obtained before main construction.

These are generic global/India-blended ranges, not commitments. Always localise.

S. No. Project Type & Size Typical Construction Duration (Post-approval)
1 1,000–1,500 sq ft G+1 home 6–10 months (Walls and Dreams)
2 2,000–3,000 sq ft custom home 10–18 months (coconstruct.com)
3 10,000 sq ft simple commercial / office 4–6 months (Autodesk)
4 50,000 sq ft mid-complex commercial / institutional 8–12+ months (Autodesk)
5 50–100 bed hospital (India, NABH-oriented) 14–20 months for construction, plus commissioning
6 Multi-block campus / large hospital (100k+ sq ft) 20–30+ months

When someone claims “50,000 sq ft hospital in 8 months, end-to-end”, this matrix should prompt you to ask:

  • Are approvals excluded?
  • Is the design fully frozen?
  • Are we assuming double shifts / fast-track construction / prefabrication?
  • What’s the buffer for delays?

Plan a Medical College Campus in 2026

Worked Example – Estimating Timeline for a Mid-Size Hospital

Let’s take a 60,000 sq ft, G+4 hospital or institutional building in an Indian Tier-2 city.

Step 1 – Pre-construction (Design + Approvals)

  • Concept design, iterations with client: 2–3 months
  • Detailed design & GFCs: 2–3 months (can overlap with concept stage)
  • Authority approvals (building permit, fire, etc.): 2–4 months depending on state/Jurisdiction

Indicative pre-construction window: 4–7 months (with overlaps and proactive coordination)

Step 2 – Main construction (high-level phasing)

  1. Enabling & foundations – 2–3 months
    • Site setup, excavation, foundations, plinth, underground tanks.

  2. Superstructure – 5–7 months
    • Assume a 7–10 day slab cycle per typical RCC frame, adjusted based on crane/formwork strategy and productivity norms.
    • Use productivity norms (m³ of RCC per crew per day, m² of formwork per carpenter per day) from IS/CPWD references to check whether crew sizes match the claimed cycle.

  3. Brickwork & plastering – 3–5 months (overlapping)
    • Start brickwork on lower floors while structure rises above.
    • Duration depends on wall areas, door/window % and number of mason teams.

  4. MEP rough-ins & testing – 4–6 months (overlapping)
    • Riser shafts, main ducting, riser cables, plumbing stacks.
    • For hospitals: oxygen, vacuum, medical air, nurse call systems, BMS.

  5. Finishes & final MEP – 4–6 months
    • Flooring, ceilings, doors, painting, fixtures, final electrical, etc.

  6. Commissioning & handover – 2–3 months
    • Integrated systems testing, mock drills, infection-control validation (for healthcare), authority inspections, and occupancy certificates.

With smart overlaps, a realistic construction + commissioning duration could be: 14–18 months, if designs are frozen and approvals are in place.

Now apply buffers:

  • Add ~15% for micro-delays and productivity loss
  • Add another ~10% for external risks (approvals slippage, funding, unforeseen issues)

Your board-level communication might therefore be: Target: 16 months, Committed range: 18–20 months post-approval.

Which construction contractors will be best for your project in 2026

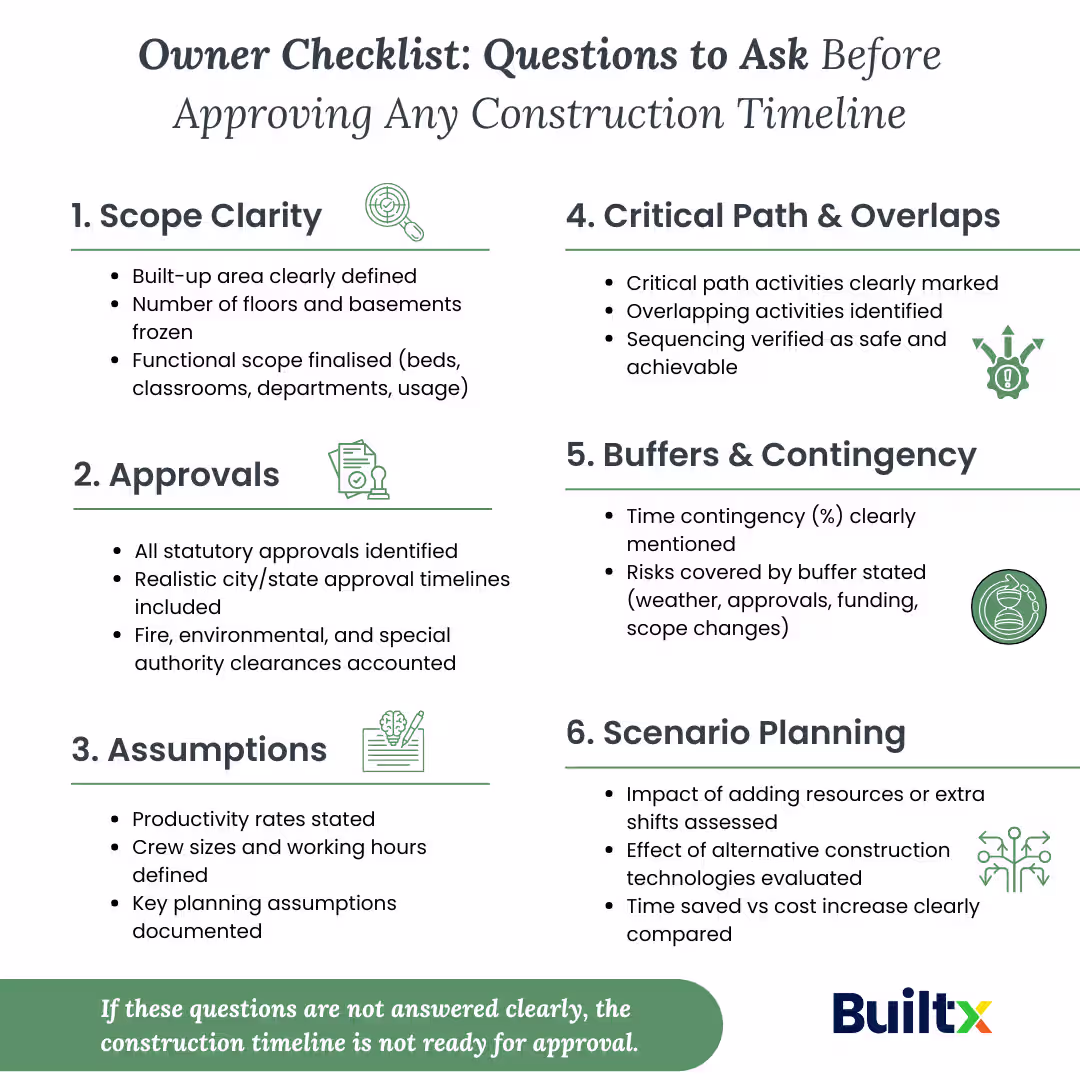

Questions to Ask Before Approving Any Timeline

How to Estimate Construction Timeline for Any Project (2026 Guide)

Top 10 Hospital Design Requirement in 2026

Conclusion

In 2026, estimating a construction timeline is not about guessing months, it’s about planning execution realistically.

As this guide shows, accurate construction timelines are built by breaking projects into phases, grounding durations in quantities and productivity, accounting for India-specific approval timelines, and adding buffers for real-world risks. When any of these are ignored, delays are almost inevitable.

For complex projects like hospitals, educational campuses, and CSR infrastructure, the difference between an optimistic schedule and a workable one lies in early clarity, transparent assumptions, and disciplined planning.

This is the approach BuiltX follows when planning institutional and healthcare projects, treating timelines as an outcome of design, approvals, execution strategy, and risk management, not as a sales promise. If you’re looking for a construction partner that prioritises predictability, transparency, and on-ground execution, BuiltX can help you plan and deliver with confidence.

Use the frameworks in this guide to challenge unrealistic schedules, ask better questions, and commit to timelines that can actually be delivered.

Book your free call now!

Together, let’s build spaces that matter.
