Introduction

A charitable trust approves ₹5 crore for a new hospital block. The budget looks reasonable. Construction begins.

Six months later, the revised forecast becomes ₹5.6 crore. A few months after that, it reaches ₹6 crore. The board asks the obvious question:

‍

Where did the extra ₹1 crore come from?

In most projects, the answer is not one major mistake.

A construction cost overrun usually builds gradually through gaps between what the original budget assumed, what the design eventually required, what the contractor priced and what the site actually needed.

For hospitals, schools, NGOs, charitable trusts and CSR-funded infrastructure projects, this becomes particularly serious because funding is often approved against a defined budget and scope.

The good news is that many overruns give warning signs early.

The challenge is identifying them before they become expensive.

Do you need a construction partner in 2026?

‍

‍

What Is a DPR in Construction?

A construction cost overrun happens when the expected or final cost of a project exceeds the budget originally approved.

Owners generally need to track three numbers:

Term Meaning
Approved budget Amount sanctioned for the project
Forecast cost at completion Current estimate of what the completed project is likely to cost
Final project cost Actual total after completion and settlement of bills

The most important number during construction is usually the forecast cost at completion.

A project may have spent only 40% of its budget and still be heading towards a major overrun because expensive packages such as MEP systems, lifts, finishes and external works often come later.

This is why cost control should focus not only on: “How much have we spent?”

but also: “What will this project cost when it is finished?”‍

‍

‍

How a ₹5 Crore Project Becomes ₹6 Crore

A ₹1 crore overrun rarely appears as one ₹1 crore event.

It can develop through several smaller changes.

Event Illustrative Cost
Unexpected excavation and ground conditions ₹10 lakh
Electrical upgrades ₹12 lakh
Fire-safety related design changes ₹8 lakh
Material escalation ₹15 lakh
Additional built-up area ₹20 lakh
Rework due to coordination issues ₹7 lakh
Delayed procurement and extended site overheads ₹10 lakh
Additional scope requested during construction ₹18 lakh
Total ₹100 lakh

These figures are illustrative and not industry averages.

No single item looks disastrous.

Together, they add ₹1 crore to a ₹5 crore project a 20% increase.

This is how many real construction cost overruns develop

How to Estimate Construction Timeline for Any Project

‍

‍‍

Major Causes of Construction Cost Overruns

1. An Unrealistic Initial Budget

Many project budgets begin with a simple calculation:

Built-up area × assumed cost per square foot

This can be useful during very early feasibility, but it becomes risky when treated as the final project budget.

The rate may come from:

  • an older project,
  • another city,
  • a simpler building,
  • different specifications, or
  • a project that did not include major MEP or external works.

A basic school block cannot be budgeted using the same assumptions as a hospital with HVAC, medical gases, lifts, fire systems and specialised electrical infrastructure.

What owners should do

Prepare an elemental estimate covering:

  • structure,
  • finishes,
  • electrical,
  • HVAC,
  • plumbing,
  • fire systems,
  • specialised services,
  • external development,
  • professional fees, and
  • contingency.

At an early stage, it is often better to communicate the budget as a range rather than pretending the number is already exact.

2. Tendering Before the Design Is Complete

When contractors receive incomplete drawings, they still have to quote.

Uncertainty then appears through:

  • assumptions,
  • exclusions,
  • provisional sums,
  • missing quantities, or
  • qualifications.

The missing information eventually returns as variations during construction.

But by then, the owner no longer has the same competitive pricing environment available during tendering.

What owners should do

Tender only after architectural, structural and MEP information has been sufficiently developed and coordinated.

If some items remain provisional, make their total value visible from the start.

3. Scope Creep

Scope creep is the gradual addition of work after the budget has already been approved.

Examples include:

  • additional rooms,
  • upgraded lobby finishes,
  • a larger DG set,
  • more toilets,
  • a better facade,
  • additional landscaping.

Each request may appear small in isolation.

But an additional room may also require lighting, HVAC, electrical points, plumbing, fire detection and furniture.

What owners should do

Freeze the project brief at an agreed stage.

After that, every change should show:

  1. why it is required,
  2. full cost impact,
  3. programme impact,
  4. impact on other systems, and
  5. cumulative value of all approved changes.

4. Poor Site Investigation

Ground conditions can quickly create additional cost.

Unexpected rock, groundwater, buried utilities, retaining requirements or access constraints may lead to:

  • deeper foundations,
  • rock cutting,
  • dewatering,
  • shoring,
  • utility diversion, and
  • additional retaining walls.

Once the contractor is mobilised, options become limited.

What owners should do

Complete appropriate:

  • geotechnical investigation,
  • topographical survey,
  • utility mapping, and
  • site due diligence

before finalising the design and tender quantities.

5. MEP Planning Starts Too Late

This is especially important in hospitals and other services-heavy buildings.

Electrical systems, HVAC, plumbing, fire protection, medical gases, lifts and IT infrastructure all need physical space within the building.

If these systems are considered only after architecture and structure are substantially fixed, problems appear on site.

Typical consequences include:

  • insufficient shafts,
  • core cutting,
  • lowered ceilings,
  • relocated equipment,
  • inadequate plant rooms, and
  • increased electrical or cooling capacity.

What owners should do

Bring MEP consultants into the project early.

Major power, cooling, water, equipment and medical-gas requirements should be understood before construction drawings are finalised.

Architecture, structure and MEP should then be coordinated together.

6. Delays and Weak Procurement Planning

A delay costs money even when no new work is added.

Site supervision, labour, contractor overheads, equipment rental and consultant costs continue every month.

Material prices may also rise while the project waits.

Long-lead equipment can make this worse.

Depending on the project, this may include:

  • lifts,
  • transformers,
  • DG sets,
  • chillers,
  • electrical panels,
  • medical equipment interfaces, and
  • specialised HVAC systems.

What owners should do

Prepare a realistic project programme and a separate procurement schedule for long-lead packages.

Track:

Specification → Approval → Order → Manufacturing → Delivery → Installation

for every critical item.

7. Rework and Poor Coordination

Rework means paying twice for the same area.

A wall opened because a service conduit was missed may require:

  1. demolition,
  2. debris removal,
  3. service installation,
  4. reconstruction,
  5. plastering,
  6. painting, and
  7. delay to the next trade.

In healthcare projects, these changes can become particularly disruptive because services and clinical environments often require tighter coordination.

What owners should do

Use:

  • coordinated drawings,
  • pre-start checks,
  • mock-ups,
  • approved samples,
  • inspection checklists, and
  • sign-offs before work is concealed.

8. Slow Owner Decisions

Sometimes the project team is not the only source of delay.

Decisions may wait for:

  • trustee meetings,
  • donor feedback,
  • management approval,
  • user confirmation, or
  • committee decisions.

Meanwhile, the site continues to incur cost.

What owners should do

Prepare a decision schedule showing:

  • decision required,
  • responsible person,
  • required date, and
  • approval authority.

Small operational decisions should not need the same approval route as major financial changes.

‍

‍

‍

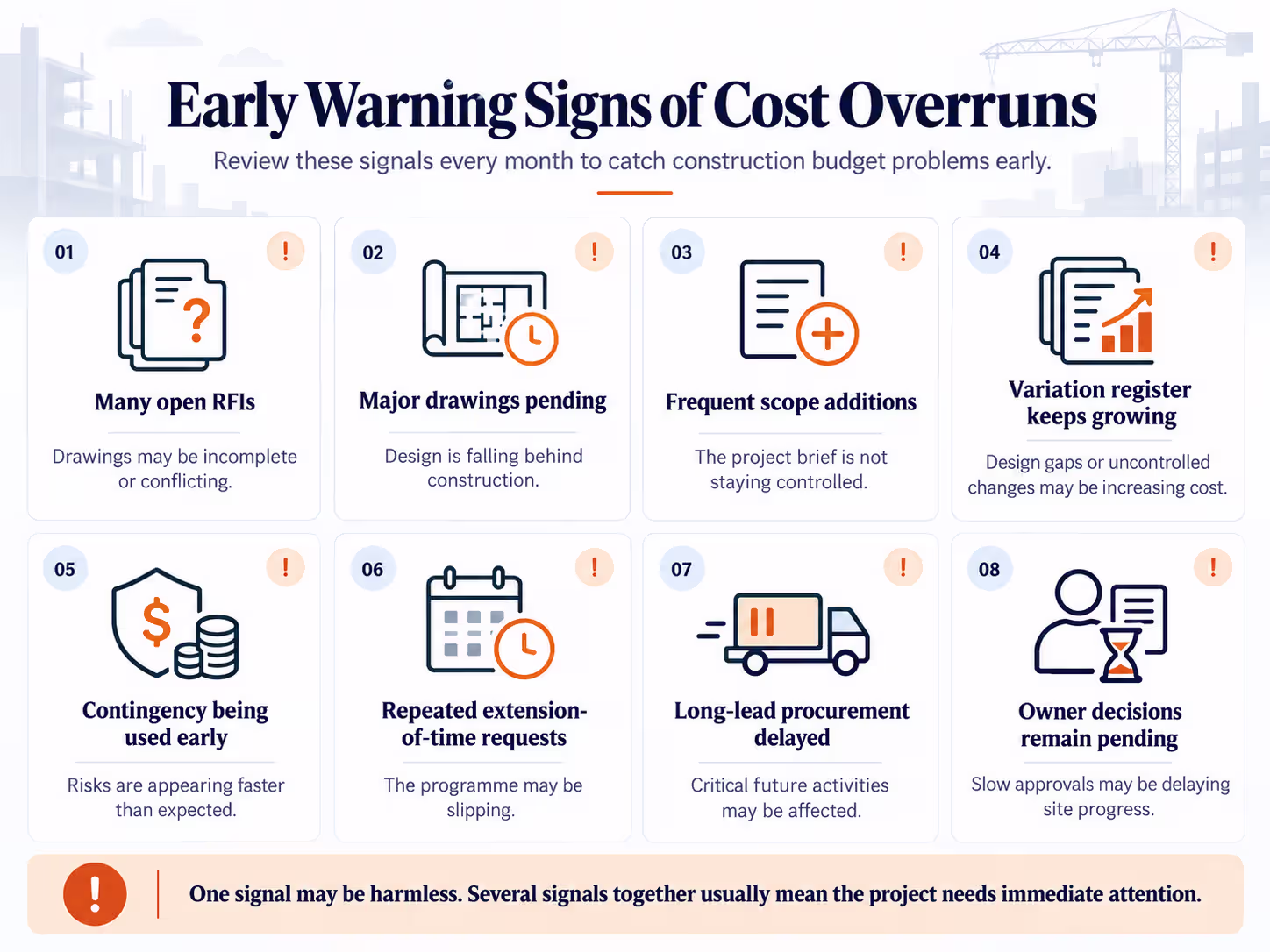

Early Warning Signs of Cost Overruns

Most construction cost overruns provide warning signs before the final forecast becomes alarming.

Warning Sign What It May Indicate
Many open RFIs Drawings may be incomplete or conflicting
Major drawings pending after construction starts Design is behind execution
Large provisional sums Tender scope is not sufficiently defined
Frequent scope additions The brief is not controlled
Contingency being used early Risks are appearing faster than expected
Repeated extension-of-time requests Programme is slipping
Long-lead procurement is delayed Future activities may be affected
Variation register keeps growing Design gaps or uncontrolled change
Owner decisions remain pending Site progress may be getting delayed

One warning sign may not be serious.

Several warning signs continuing together should trigger a deeper review.

10 ways to achieve sustainaible design in India in 2026

‍

‍

Before Design

Write a Clear Project Brief

Define:

  • spaces,
  • areas,
  • occupancy,
  • services,
  • equipment,
  • finish expectations, and
  • future expansion.

For healthcare projects, major clinical functions and equipment should be understood early because they directly affect architecture and MEP.

Test the Project Against Available Funding

If the institution can realistically fund ₹5 crore but the proposed brief is likely to cost ₹8 crore, that problem should be resolved before design advances.

Separate Essential and Optional Scope

Classify requirements as:

  • Essential
  • Desirable
  • Phaseable

This becomes extremely useful later when trade-offs are required.

‍

‍

During Design

Design to the Budget

Do not complete the design and calculate the cost afterwards.

Cost targets should influence decisions while alternatives are still being explored.

Coordinate All Disciplines

Architecture, structure and MEP should progress through common review cycles.

Re-estimate Regularly

Review estimated cost at:

  • concept stage,
  • schematic design,
  • detailed design, and
  • pre-tender stage.

If the cost starts moving, correct it while the solution still exists on paper.

Apply Value Engineering Early

Value engineering should ask:

Can we achieve the required function more efficiently?

It should not simply mean reducing quality.

Structural systems, facade options, HVAC strategies and material specifications often have more room for optimisation during design than during construction.

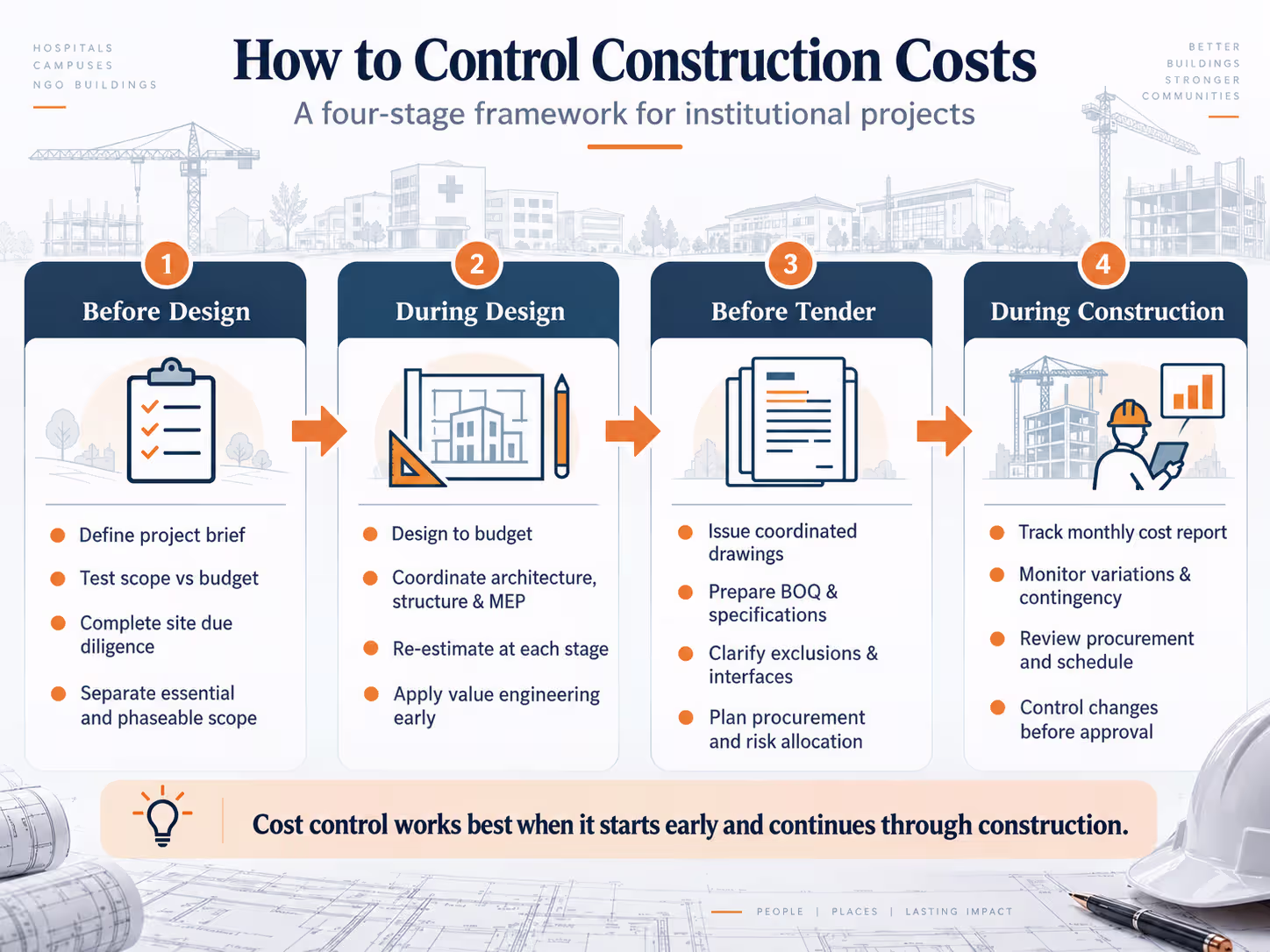

Process graphic: How to Control Construction Costs

  • Four stages:
    Before Design → During Design → Before Tender → During Construction
  • This would visually summarize a large part of the article without adding more text

Hospital Construction Requirements in India

‍

‍

Before Tender

Before inviting contractors:

  • coordinate architecture, structure and MEP,
  • prepare a detailed BOQ,
  • define specifications,
  • clarify exclusions,
  • identify provisional items,
  • define package interfaces,
  • establish contract risk allocation, and
  • prepare the procurement schedule.

A low tender based on incomplete information does not necessarily result in a low final project cost.

‍

‍

‍

Before Approving Any Change, Ask These Questions

Before approving additional work, ask:

  1. Why is the change required?
  2. Is it mandatory or optional?
  3. What is the full cost impact?
  4. Will it delay the programme?
  5. Which other systems will it affect?
  6. If the budget is fixed, where will the saving come from?
  7. Who has authority to approve it?

This simple discipline prevents many small decisions from quietly turning into a large overrun.

Phased Hospital Construction vs Single-Phase Construction in 2026

‍

‍

What If the Project Is Already Over Budget?

Once the forecast has exceeded the approved budget, random cost cutting usually makes the situation worse.

A better recovery sequence is:

1. Freeze Non-Essential Changes

Stop adding optional scope until the financial position is clear.

2. Update the Forecast Cost at Completion

Include:

  • remaining contracts,
  • pending variations,
  • claims,
  • likely escalation, and
  • unresolved risks.

3. Separate Committed and Uncommitted Cost

Focus on packages where the project still has room to make decisions.

4. Prioritise Remaining Scope

Divide it into:

  • essential for safe operation,
  • important after opening, and
  • optional.

5. Review Remaining Procurement

Look for opportunities to re-tender, consolidate orders or review equivalent specifications.

6. Value-Engineer Remaining Work

Find lower-cost ways to deliver the required performance without compromising safety or functionality.

7. Rephase Where Necessary

Complete and commission the essential project first.

Move genuinely optional work into a defined future phase.

‍

‍

‍

Cost Control in Hospitals and NGO Projects

Institutional projects require particular care because their budgets are often less flexible.

Healthcare projects can experience cost increases when:

  • equipment is selected late,
  • electrical loads increase,
  • medical gases are added late,
  • clinical layouts keep changing,
  • HVAC requirements are not defined early, or
  • future expansion is ignored.

NGO and CSR-supported projects may face another challenge: funding and construction programmes do not always move at the same pace.

For these projects, it is especially useful to:

  • align construction milestones with expected funding,
  • report forecast costs consistently,
  • define contingency approval clearly,
  • document scope changes, and
  • select systems that the organisation can maintain after handover.

‍

‍

‍

The Role of a PMC or Preconstruction Consultant

A project management consultant cannot guarantee that a project will never face an increase.

Site risks, market movements and genuine scope changes will still occur.

The real value of project management is making these risks visible early.

This can include:

  • developing realistic budgets,
  • coordinating design disciplines,
  • checking costs as design develops,
  • preparing procurement plans,
  • managing variations,
  • monitoring progress, and
  • tracking risks and contingency.

Cost control is not one estimate prepared at the beginning of the project.

It is a continuous process from feasibility to handover.

‍

‍

‍

FAQs

What is a construction cost overrun?

A construction cost overrun occurs when the expected or final cost of a project exceeds the approved budget.

What are the main causes of construction cost overruns?

Common causes include unrealistic budgets, incomplete design, scope creep, inadequate site investigation, late MEP planning, project delays, rework, weak procurement and slow decisions.

How can owners detect a cost overrun early?

Watch for growing variations, open RFIs, delayed drawings, early use of contingency, procurement delays and repeated scope changes.

How can construction costs be controlled?

Cost control should begin before construction through better budgeting, coordinated design, detailed BOQs, procurement planning, change control and regular forecasting.

What should you do when a construction project is already over budget?

Freeze optional changes, update the forecast cost at completion, separate committed and uncommitted costs, prioritise remaining work and value-engineer work that has not yet been executed.

Can a PMC help prevent construction cost overruns?

A PMC cannot eliminate every market or site risk, but effective project management can reduce avoidable overruns through better coordination, cost monitoring, procurement planning, change control and progress tracking.

‍

‍

‍

The Overrun Is Decided Long Before It Appears

A project rarely becomes expensive overnight.

The ₹6 crore forecast that worries the board in month eighteen may have started taking shape months earlier:

  • the original budget relied on an unrealistic rate,
  • tendering began before design coordination was complete,
  • MEP loads were finalised late,
  • scope was added without checking its full impact,
  • procurement decisions slipped, or
  • coordination issues reached the site instead of being solved on drawings.

Projects that remain close to budget are not simply luckier.

They connect scope, design, cost, MEP, procurement, schedule and construction from the beginning.

And they repeatedly ask the most important question:

What will this project cost when it is finished?

Planning a Hospital, Campus or NGO Infrastructure Project?

BuiltX works with organisations to evaluate project feasibility, test budgets against the project brief, coordinate architectural, structural and MEP planning, and identify execution risks before they become expensive site problems.

If you are preparing a new hospital, educational facility, institutional campus or nonprofit infrastructure project, early planning can create far more opportunities to control cost than late-stage corrections.

Talk to the BuiltX team about your project →

‍

Together, let’s build spaces that matter.

get in touch
